This guide is for Product Managers who need a defensible way to prioritize work when the roadmap is overloaded and everyone says their thing is “urgent”. Cost of Delay is the value you lose per unit of time by not delivering a capability yet - it turns deadline debates into economic decisions. In SAFe, WSJF ranks work as Cost of Delay / Job Duration, so you ship the highest economic impact fastest. CoD allows companies to prioritize initiatives that will deliver the highest economic return in the shortest amount of time.
-
Cost of Delay is a rate (like $/week), so you can prioritize with numbers instead of gut feel.
-
Start with baseline CoD/week = weekly value created or protected after release, then document assumptions as ranges.
-
WSJF = Cost of Delay ÷ Job Duration, so the highest value-per-time should ship first (SAFe).
-
Sequencing matters at portfolio level, because one shared queue makes every week on one item delay the rest and raise total delay cost.
-
“Buying time” only pays off when CoD/week × weeks saved is greater than the added cost plus onboarding tax.
What is cost of delay?
Cost of Delay is the value you lose per unit of time by not delivering a capability yet. SAFe’s WSJF page reinforces the same idea with a rule of thumb: if you quantify only one thing, quantify Cost of Delay.
Here’s the thing: “late” is a schedule word, but “expensive to wait” is an economics word. That framing changes decision making because you stop arguing about vibes and start pricing time. CoD can affect customer satisfaction and brand reputation if the delayed feature or product is critical to the market.
Think of Cost of Delay as “money per time,” like $/week. Once delay cost has a unit, two initiatives become comparable on one scale. Definition box: Cost of Delay = lost value while you wait, measured as $/time. PMI describes Cost of Delay in terms of value lost from waiting, such as lost revenue, missed opportunity, or risk exposure. Understanding CoD is essential for maximizing portfolio value.
Cost of Delay is not a feeling, it is a rate. A rate forces clarity because you must name what “value” means for this work. It can be lost revenue, avoided cost, reduced risk, or protected customer satisfaction. PMI explicitly frames Cost of Delay around these “lost value while waiting” components, not around team effort or how loud stakeholders are. For example, if a feature is expected to earn $10,000 per month and is delayed by three months, the cost of delay is $30,000.
If you can express delay as $/week, you can defend priorities without gut feel. That single unit turns “this is important” into “this costs us X each week we wait.” It also makes trade-offs visible because opportunity cost becomes a number instead of a vague concern. SAFe’s WSJF guidance points to the same logic: quantify Cost of Delay so prioritization is anchored in economic impact. Calculating revenue lost per unit of time allows teams to identify high-impact initiatives and optimize delivery times.
How do you calculate cost of delay per week?
Start with one number: the weekly value created or protected after release, and treat that as your baseline Cost of Delay per week. SAFe frames Cost of Delay as the key economic variable to quantify, and WSJF uses it directly when ranking work.
That baseline is your delay cost in plain units like $/week. It gives stakeholders one scale for decision making. Delaying a product launch can result in missed market opportunities and increased competition.
First, determine what “value” means for this work, then attach a weekly number to it. Value can be revenue uplift, cost savings, revenue protection, risk reduction, compliance, or opportunity enablement. PMI describes Cost of Delay as value lost from waiting, including lost revenue, missed opportunity, and risk exposure. CoD analysis helps product teams compare ideas and initiatives of different sizes on a level playing field.

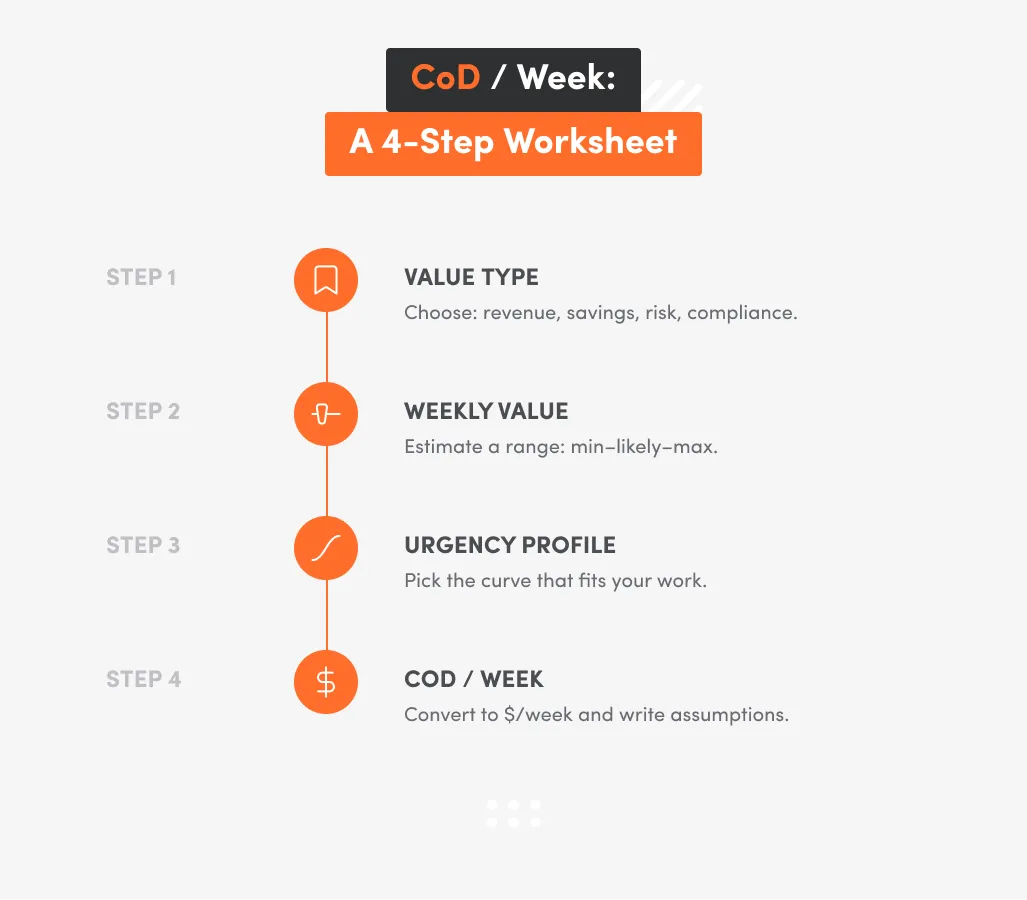

Use this 4-step worksheet to calculate cost and document the data points behind it. Step 2 uses a range so you can quantify uncertainty without fake precision. Mini-case: a feature that saves 30 hours per week at $50 per hour has a baseline Cost of Delay of $1,500 per week, and that number exists before any cod analysis or debate about scope. These four steps keep “estimate cost of delay” tied to a time period, not opinions. Using Kanban boards can help visualize workflow and identify bottlenecks related to Cost of Delay.
- Identify value type (revenue, savings, risk, compliance).
- Estimate weekly value after release (range).
- Choose urgency profile (fixed date, standard, expedite, intangible).
- Convert to CoD/week and document assumptions.
Cost of Delay only helps if you pair the weekly number with duration, because duration defines how long you will keep paying the delay cost. Write down expected duration and project duration in the same units, like weeks. If you deliver two weeks earlier, you avoid two weeks of baseline CoD, and that avoided cost is the benefit you compare against resourcing or scope changes. Cost of Delay analysis helps product teams compare ideas and initiatives of different sizes on a level playing field, objectively prioritize them, and communicate their decision to stakeholders.
Try our developers.
Free for 2 weeks.
No risk. Just results. Get a feel for our process, speed, and quality — work with our developers for a trial sprint and see why global companies choose Selleo.
Which urgency profile fits your work and how does it change the delay cost curve?

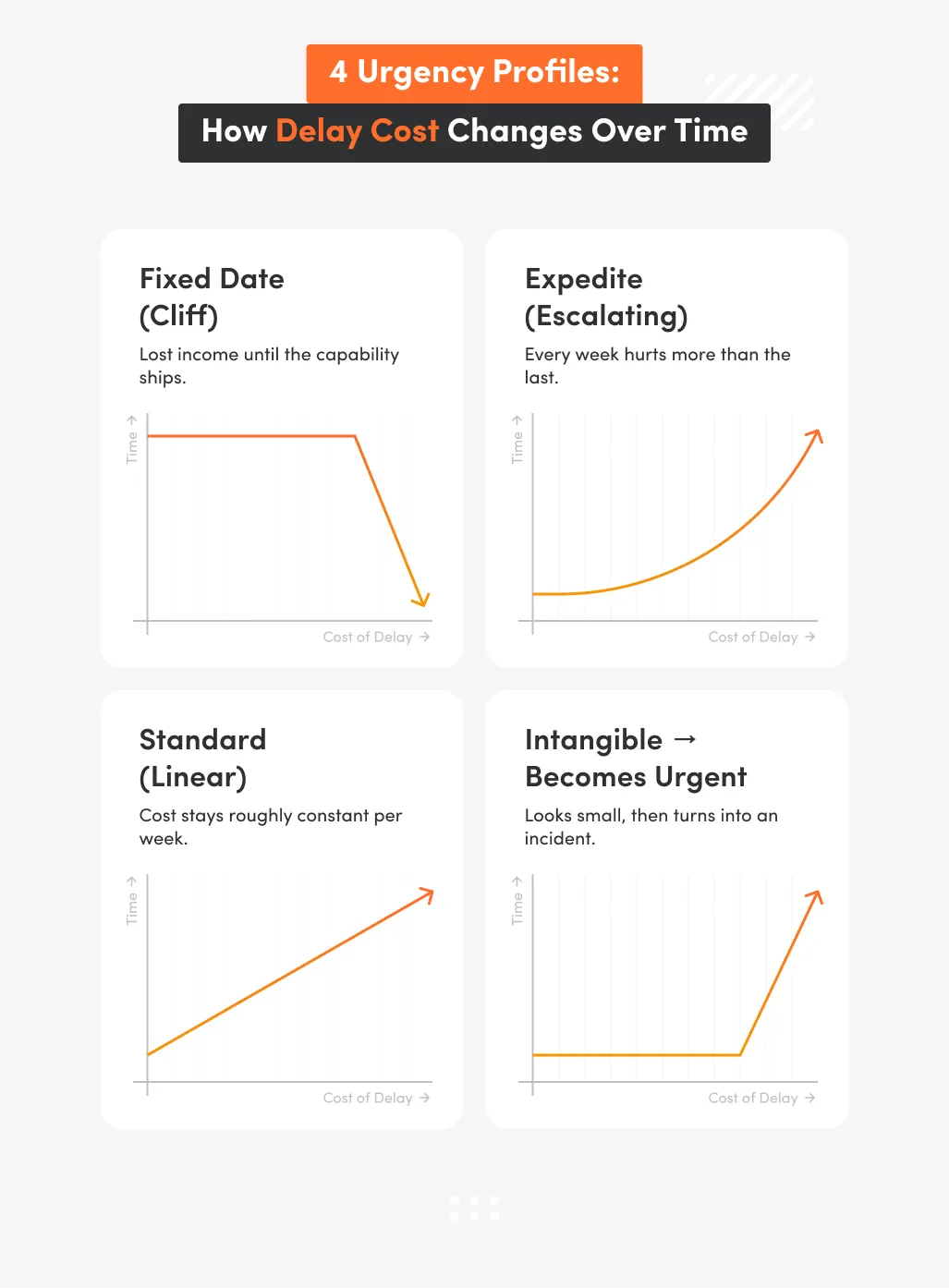

An urgency profile describes how your Cost of Delay changes over time, not just how “important” the work feels. In SAFe’s WSJF guidance, Cost of Delay explicitly includes time criticality and risk reduction / opportunity enablement, so urgency is part of the economic model.
That’s where it gets tricky: two items can have the same business value, but one turns into a disaster when it slips.
Use one test to pick the urgency profile: “What happens if we deliver two weeks later?” If the answer is “nothing changes,” you are dealing with a standard curve. If the answer is “value collapses” or “risk spikes,” time criticality is driving the decision, not effort or stakeholder volume. SAFe treats time criticality as a first-class input to prioritization, which is why this test works in real decision making.
Fixed-date work has a “cliff” because value depends on hitting a deadline. If you ship after that date, the economic impact can drop sharply, sometimes close to zero for that specific window. Expedite work is different: every hour of delay increases loss because customers cannot use a critical path, risk stays unresolved, or revenue is actively leaking. Mini-case: a compliance requirement tied to a legal deadline is fixed date, while an outage that blocks checkout is expedite.
Standard and intangible work still have urgency, but they need different handling in your product roadmap. Standard work loses money at a steady rate, so the delay cost curve is close to linear across the time period. Intangible work starts with low visible monetary value, but it accumulates risk until it turns into an incident, and then it becomes expedite. That shift is why strategic decisions about tech debt belong in the same cod analysis as new feature delivery, not in a separate bucket. SAFe’s Cost of Delay inputs include risk reduction and opportunity enablement, so “intangible” work can be priced through risk even when revenue uplift is indirect.
How does WSJF (Cost of Delay divided by duration) change your backlog order?
WSJF changes your backlog order by ranking work as Cost of Delay divided by Job Duration, so the highest “value-per-time” ships first. SAFe defines WSJF as (relative) Cost of Delay / (relative) Job Duration on its WSJF. That single rule replaces “team priority” debates with a consistent way to prioritize tasks.
Here’s the thing: WSJF is a sequencing rule, not a promise about total expected value. It answers “what first?” when multiple features compete for one team. It rewards the shortest duration when Cost of Delay is similar, because shorter work unlocks value sooner and frees capacity for the next item. SAFe attributes the core idea to Don Reinertsen’s economic view of product development, which focuses on pricing time, not opinions.
You can run a WSJF mini-check with three backlog items and basic data points. Use expected duration in weeks and a CoD/week estimate, then do the same “delay divided by duration” math for each item. Example: A has CoD $10k/week and effort 5 weeks, so WSJF=2; B has CoD $40k/week and effort 1 week, so WSJF=40; C has CoD $50k/week and effort 2 weeks, so WSJF=25. The WSJF order is B → C → A, even though C has the biggest weekly number, because B has the highest value-per-time.
WSJF works best when you treat the inputs as relative estimates and ignore sunk costs. If a low-WSJF item already started, “we invested so much” is not a sequencing signal. Keep a cod focus on the next decision: what delivers the most economic impact per week of work from today. SAFe’s WSJF definition supports this framing by tying priority to Cost of Delay and Job Duration rather than historical spend.
Why can “doing the biggest thing first” increase total delay cost across a portfolio?
Doing the biggest thing first increases total delay cost because one shared team creates a single queue, and every week spent on one item delays the rest. The Maersk case study describes prioritizing work by cost of delay divided by duration (CD3) to “block the pipeline for less time,” which targets the same portfolio problem.
Here’s the thing: this is not about local ROI. It is about flow and opportunity cost inside one bottleneck.
A portfolio is a system with shared resources. When product teams run high WIP, they create queues that stretch cycle time. Longer cycle time lowers throughput because the bottleneck stays busy while everything else waits. The result is hidden opportunity cost: multiple items keep accruing delay cost at the same time, even if only one item is being built. CoD exposes hidden costs of project delays, such as waiting for approvals or stakeholder feedback.
A simple business example shows why sequencing often beats “doing the biggest thing first.” Imagine one team and three items: A costs $10k per week in Cost of Delay and takes 5 weeks, B costs $40k per week and takes 1 week, and C costs $50k per week and takes 2 weeks. If the team starts with C, then builds B, and only then does A, the waiting cost adds up to $110k: while C is in progress for 2 weeks, both A and B are waiting, so you pay ($10k + $40k) × 2 = $100k, and while B is in progress for 1 week, A is still waiting, so you pay another $10k. If the team instead starts with B, then does C, and finishes with A, the waiting cost drops to $80k: during B’s 1 week, A and C are waiting, so you pay ($10k + $50k) × 1 = $60k, and during C’s 2 weeks, A waits another $20k. The $30k difference comes from portfolio math and queueing effects, not from changing the underlying business value of the work.
The fix is to manage the queue, not to “work harder.” Sequencing that reduces pipeline blocking lowers total delay cost because it shortens waiting time across multiple features at once. That is why the Maersk CD3 example still matters even though it is from 2011: the constraint is structural in any single-stream delivery system. If you want a mental model, Little’s Law links WIP, throughput, and cycle time in one relationship.
When is “buying time” with contractors or staff augmentation economically worth it?
Buying time is worth it when avoided Cost of Delay (CoD/week × weeks saved) is larger than the added cost plus onboarding tax. SAFe defines WSJF as (relative) Cost of Delay / (relative) Job Duration, which is why you must price time before you allocate resources to speed.
Start with the break-even rule, not a gut check. Buying time means you pay money to reduce duration on a critical path. The benefit is avoided delay cost, and the cost is contractors plus onboarding tax. Mini-case formula: if CoD is $20,000 per week and you save 4 weeks, avoided CoD is $80,000.
Onboarding tax is real because new people create communication overhead before they create throughput. That tax shows up as time spent on ramp-up, reviews, context sharing, and rework. The shorter the remaining project duration, the more that overhead dominates, and the less “buying time” delivers. Brooks’ Law is the classic warning that adding people to a late project can make it later.
Use a sensitivity check to avoid fake precision in decision making. Write CoD/week as a range, then multiply by weeks saved to generate an avoided value range.
Quick grid:
$10k/week × 1 week = $10k;
$10k/week × 4 weeks = $40k;
$50k/week × 2 weeks = $100k.
If the avoided range does not clear the total cost plus onboarding tax, do not allocate resources to accelerate. A neutral delivery option for this scenario is staff augmentation for software teams, because it makes the “marginal cost for weeks saved” explicit.
Answer one objection early: “contractors will slow us down.” That statement is correct when ramp-up consumes the small time period left in the plan. It is false when the remaining duration is long and the weekly delay cost is high, because net weeks saved stay positive after onboarding. Transparent, direct communication with the engineers doing the work reduces onboarding tax by cutting handoffs and avoiding the “telephone game.” If you’re unsure whether extra capacity will help or hurt, start with a short pilot sprint (a risk-free test drive) to validate collaboration before you scale. Mini-case: CoD $100k/week, weeks saved 3, contractor cost $70k, onboarding tax $40k gives net value $190k ($300k − $110k).
PM objections when adding external capacity
- Vendor will slow us down - not speed us up.
It’s true when context transfer and review overhead exceed the throughput you gain. Mitigation: start with a small, clearly-scoped slice of work, set a tight feedback loop (demo + review cadence), and measure lead time and rework in week 1–2. - We’ll get a “ticket factory,” not product delivery.
This happens when the external team is optimized for output, not outcomes. Mitigation: align on success metrics (impact, not tickets), keep discovery close (even lightweight), and enforce a Definition of Done that includes quality and acceptance criteria. - Communication won’t be fast or concrete enough.
This happens with too many intermediaries and unclear ownership. Mitigation: direct access to the people building the feature, single thread for decisions, and an agreed escalation path for blockers. - I’ll become a translator between business and the vendor.
This happens when the partner can’t think in product terms. Mitigation: require a shared backlog language (user outcomes + constraints), shared rituals (weekly demo, backlog refinement), and written assumptions that reduce “interpretation” work.
Pilot sprint checklist
- Onboarding: who joins, what context is needed, and what “good” looks like in week 1.
- Product context handoff: users, value proposition, constraints, and current roadmap assumptions.
- Demo / status rhythm: cadence (e.g., weekly demo), what gets shown, and who signs off.
- Tools and workflow: Jira/Linear, docs, Slack/Teams channels, and how decisions are logged.
- Definition of Done: tests, review standards, acceptance criteria, and release checklist.
- Feedback loop: how quickly you expect changes after review, and how you handle scope questions.
Can AI reduce Cost of Delay or accidentally increase it (DORA 2024)?
Yes, AI can increase Cost of Delay when it extends lead time or adds rework, even if coding feels faster. DORA 2024 reports that as AI adoption increased, delivery throughput decreased by about 1.5% and delivery stability dropped by about 7.2%.
Cost of Delay is paid in time, so duration is the part that decides how long you keep paying. If the delivery system slows down, the delay cost curve moves up.
A faster coder does not guarantee a faster system. The failure mode is simple: more code creates a code review bottleneck and raises change failure rate. When reviews and tests become the constraint, throughput falls and cycle time grows. DORA’s throughput and stability deltas are the evidence that this system effect shows up in real delivery data.
Treat AI adoption as a delivery change, not a typing-speed change. You need to track lead time, throughput, and stability as core data points in any delay analysis. If you deploy new artificial intelligence solutions and the number of changes rises, the review queue gets longer and defects become more expensive. Mini-case: AI generates a bigger changelist, one senior reviewer becomes the bottleneck, and the “time-to-value” clock slows down for customers. DORA’s 2024 results quantify the risk with the -1.5% throughput and -7.2% stability signals.
Use this causal chain to explain the mechanism in one line: AI adoption → more changes → bottlenecks or failures → longer lead time → higher Cost of Delay. This is why “competitive advantage” depends on flow, not on the amount of code produced. DORA 2024 gives you numbers to anchor that statement to business outcomes.
Which prioritization approach should you use: HiPPO, ROI-first, MoSCoW, or CoD/WSJF?
Use CoD/WSJF when time sensitivity matters and you need a defensible backlog order; use ROI-only when timing is truly irrelevant. SAFe defines WSJF as (relative) Cost of Delay / (relative) Job Duration, so it bakes urgency into the math instead of leaving it to gut feel.
That difference changes decision making because you can prioritize initiatives with one consistent rule. It also makes trade-offs explainable to stakeholders.
HiPPO and MoSCoW are easy to start with, but they do not produce stable sequencing. HiPPO turns “prioritize tasks” into politics, not economics. MoSCoW groups work into labels, so “Must” can swallow half the roadmap and block better decisions. The result is unclear economic impact when product teams must choose what ships first.
ROI-first works when the only question is “is this worth doing at all,” not “what should we do next.” ROI and NPV focus on total expected value, but they do not price the cost of waiting unless you explicitly add time. Mini-case: two items each return $1M, but one loses $50k per week until release while the other loses $5k per week; ROI-first treats them as equals, CoD/WSJF does not. If timing is irrelevant, ROI-only can rank initiatives by value and stop there.
CoD/WSJF is the practical choice when delivery happens through a shared queue and duration is a constraint. If time criticality exists, ignoring it produces the wrong backlog order even when the spreadsheet looks “rational.” Use CoD/WSJF to justify sequencing, then keep ROI as a sanity check for whether an item belongs in the portfolio at all. Watch for Goodhart’s law when metrics become targets, and keep assumptions visible in the worksheet.
If you must choose: sequence first or add people first - what’s the safer order?
Sequence first (WSJF/CD3), then add people only for the few items with the highest weekly delay cost. The Maersk case study describes prioritizing by Cost of Delay divided by duration (CD3) to “block the pipeline for less time,” improving flow without increasing budget .
This order is safer because it reduces total cost in the value pipeline before you spend more resources.
Sequencing is a low-regret move because it changes what your existing capacity delivers first. In a shared queue, one “big first” decision can delay multiple items at once, which hurts business outcomes even when the big item looks valuable. CD3 makes that trade-off explicit, so product teams can prioritize with one consistent rule instead of status or noise. The Maersk example is proof that transparency in prioritization can change business–IT alignment and unlock benefit without adding headcount.
Use these decision rules as a narrative checklist for better decisions. If timing matters, choose CoD/WSJF because SAFe defines WSJF as Cost of Delay divided by duration, which captures time sensitivity in the ranking.
If several initiatives share one queue, choose sequencing before scaling the team because a long item blocks the value pipeline and increases total cost for everything behind it, which is exactly what CD3 tries to minimize.
If avoided CoD (CoD/week × weeks saved) exceeds added cost plus onboarding tax, then “buying time” is rational. If AI increases output but stability drops, invest in tests, review capacity, or platform work because DORA 2024 reports about -1.5% throughput and -7.2% stability as AI adoption increased.
After you fix the order, add people only where the weekly delay cost is highest and the time saved is real. That keeps “buying time” focused on a small set of critical work rather than spreading effort across the backlog. It also makes the decision explainable: you are paying to reduce duration where the economic impact per week is largest. The Maersk CD3 story supports this sequencing-first approach because it treats prioritization as a lever for value, not as a meeting outcome.
What are the most common Cost of Delay mistakes product teams make?
Product teams make Cost of Delay (CoD) mistakes when they assume certainty and ignore how urgency changes over time. SAFe’s economic view behind WSJF treats Cost of Delay as a key input, which is why your numbers must reflect time sensitivity and not gut feel.
A good understanding of CoD comes from disciplined inputs, not from a prettier spreadsheet.
Mistake #1 is treating every delay analysis as linear, even when the work has a deadline cliff. Fixed-date work does not behave like “two weeks late = two weeks of loss” when value drops sharply after a date. The fix is to assign an urgency profile before you estimate cost, then write down what “late by 2 weeks” means in business outcomes. Mini-case: a launch tied to a product launch window can lose market share in a way a normal backlog item cannot.
Mistake #2 is using single-point estimates and calling them “data points.” A single number creates false precision and pushes decision making toward arguments instead of better decisions. The fix is ranges plus sensitivity: record min / likely / max CoD/week and keep the assumptions visible. Think of CoD/week like an expected interest rate on delayed value, then test how results change across the range.
Mistake #3 is buying time before fixing sequencing, which increases total expected delay cost across the queue. If you add resources first, you can accelerate the wrong items and still block the pipeline for the rest of the product teams. Use this short checklist, then set a review cadence so numbers do not rot:
- Treating fixed-date work as linear value
- Using single-point estimates instead of ranges
- Buying time before fixing sequencing
SAFe’s WSJF framing is the reminder here: prioritize with Cost of Delay and duration, then revisit the order as inputs change.
What should you do next with your roadmap after calculating Cost of Delay?
Pick your top five initiatives, estimate CoD/week as ranges, apply WSJF, and revisit the numbers every sprint. WSJF is the sequencing model here because it ties priority to Cost of Delay and Job Duration (SAFe WSJF, updated 2023-10-09).
Make the practice small and repeatable. Keep a worksheet next to the product roadmap. Keep assumptions visible, including duration, effort, and the urgency profile.
This is roadmap hygiene, not a finance program. The point is to reduce cost from wrong ordering and make prioritization explainable in the same units every week.
Capability context (neutral, no CTA): custom software development services are easiest to justify when your highest CoD items depend on system-level changes rather than isolated feature tweaks. For subscription products, SaaS development services map cleanly to CoD because each week of delay compounds lost recurring value. In data-heavy backlogs, a python development company can shorten duration where integration and automation dominate the schedule. When the delayed value is adoption and behavior change, business training software development can have fixed-date rollout constraints. In regulated environments, custom FinTech software development often includes fixed-date work where CoD behaves like a cliff near compliance deadlines. For clinical workflows, healthcare software development mixes standard CoD for features with expedite CoD when incidents affect patient-facing systems.
Cost of Delay (CoD) is delay cost expressed as a rate, like $/week, so you can compare work on one scale. It translates business value into money per time period instead of “late vs not late.” Product managers use it to defend decision making with stakeholders when priorities conflict.
Q2: Why does “delay divided by duration” (WSJF) change what ships first?
A: WSJF is “delay divided by duration,” meaning Cost of Delay / job duration, so shortest duration wins when time sensitivity is real. It favors the highest value-per-week, not the biggest total expected value. This reduces gut feel and gives product teams a repeatable prioritization rule across multiple features.
To calculate cost fast, start with 3 data points: value per week, expected duration (in weeks), and an urgency profile. Use ranges (min/likely/max) to estimate and quantify without false certainty. This is enough for a usable cod analysis even when finance inputs are imperfect.
Cost of Delay includes lost revenue, cost savings, risk reduction, and compliance outcomes, as long as you can express the benefit per week. Customer satisfaction can be priced through churn risk or support load, but if you cannot tie it to money, mark it as a gap and keep the assumption visible. This keeps monetary value connected to business outcomes.
Use one unit for duration: weeks, and be explicit whether you mean expected duration (forecast) or project duration (committed plan). CoD/week × duration gives the total cost of waiting across that time period. If the expected duration changes, your total cost and prioritization order can change with it.
Allocate resources only when avoided Cost of Delay exceeds total cost, including onboarding and coordination overhead. If sequencing reduces queueing and frees capacity, that is the safer first step for better decisions across a company. Buying time is a second move for the highest weekly CoD items.
A task is critical when a short delay creates outsized economic impact, like market share loss at a product launch or a fixed deadline for first release. Use the question: “What changes if we deliver two weeks later?” If outcomes collapse, urgency is high and prioritization should reflect it.
In one shared team, every week on one item delays the rest, so total cost depends on flow and sequencing, not just item value. High WIP increases waiting time, which increases aggregate delay cost across multiple features. This is why prioritizing “highest value” without considering duration can backfire.
Total expected value answers “is it worth doing,” while Cost of Delay answers “what does waiting cost per week.” ROI-first can miss time sensitivity, especially when two projects have similar total expected value but different weekly loss. CoD/WSJF makes the trade-off explicit for decision making.
Total expected value answers “is it worth doing,” while Cost of Delay answers “what does waiting cost per week.” ROI-first can miss time sensitivity, especially when two projects have similar total expected value but different weekly loss. CoD/WSJF makes the trade-off explicit for decision making.
Don Reinertsen’s core idea is to price time, because delay is an economic cost, not just a schedule issue. SAFe popularized this logic in product planning through WSJF and economic prioritization. The practical takeaway for product managers is to focus on value per time, not effort theater.
The fastest ways to reduce cost are: shorten duration, reduce waiting time in the queue, or change scope to reach a valuable first release sooner. These moves improve delivery outcomes without needing perfect forecasts. Your product roadmap becomes a tool for choosing the next week’s highest impact work.
Prioritize initiatives with a shared worksheet: CoD/week range, duration, urgency profile, and the assumption behind each number. This shifts debate from “who wants it” to “what it costs to wait,” improving understanding and reducing politicized team priority decisions. It also makes trade-offs explainable without gut feel.
If value is intangible, price the risk and define the trigger that turns it into an incident, then treat it as a delay cost that escalates. This helps product teams compare tech debt to new feature work inside the same cod analysis. If you cannot quantify at all, flag it and keep it out of hard rank order.
A model is usable when it supports two actions: rank order for multiple features and a clear “buy time or not” resource decision. You need CoD/week, expected duration, and a documented time period. If changing one input flips the decision, run sensitivity and revise assumptions.
Treat CoD as a decision tool, not a performance target, and refresh the inputs on a fixed cadence. Keep the assumptions visible and update them when data points change. That protects prioritization from becoming theater and keeps focus on outcomes.
